Statement on Entergy Arkansas's $1.6B Double Dip
The news this week about Entergy Arkansas and Google has raised important questions about who pays for new energy infrastructure, how those costs are allocated, and how transparent the process should be. Google has committed significant payments associated with its new data center, while Entergy customers are also paying for the construction of Cypress Solar through the GAJA rider. The newly released information has brought renewed attention to how those payments interact and whether existing ratepayers receive the full benefit.

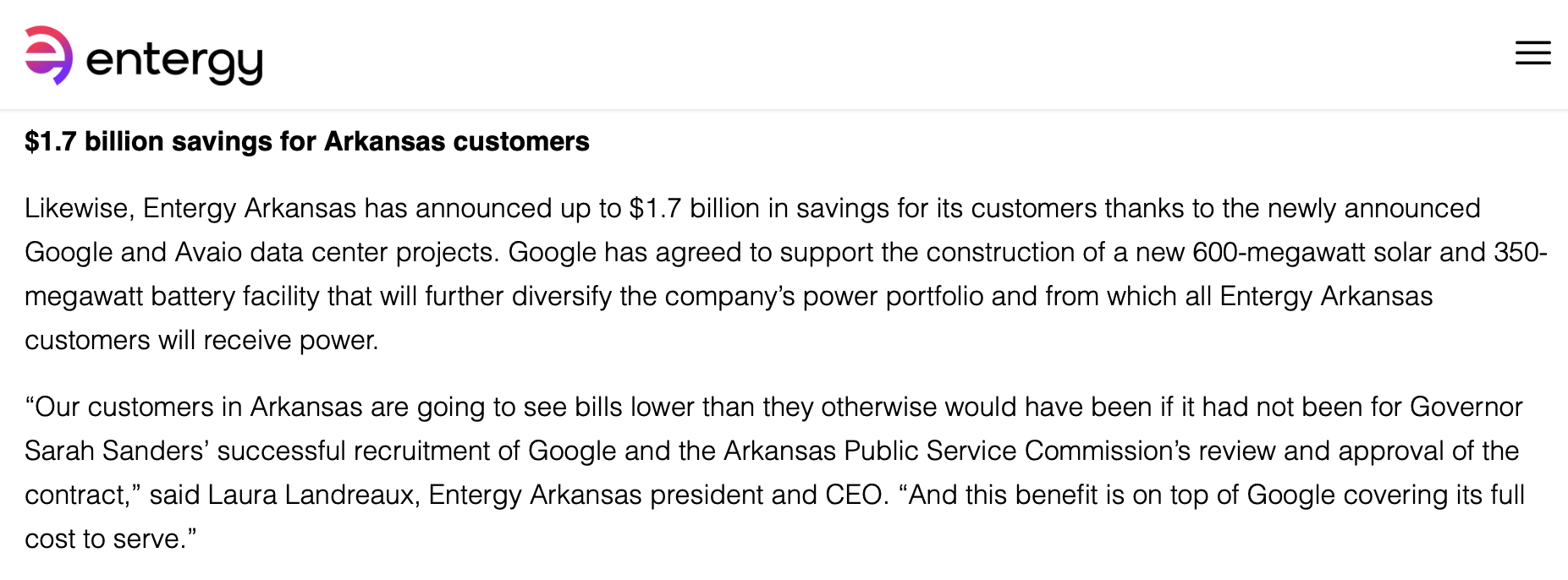

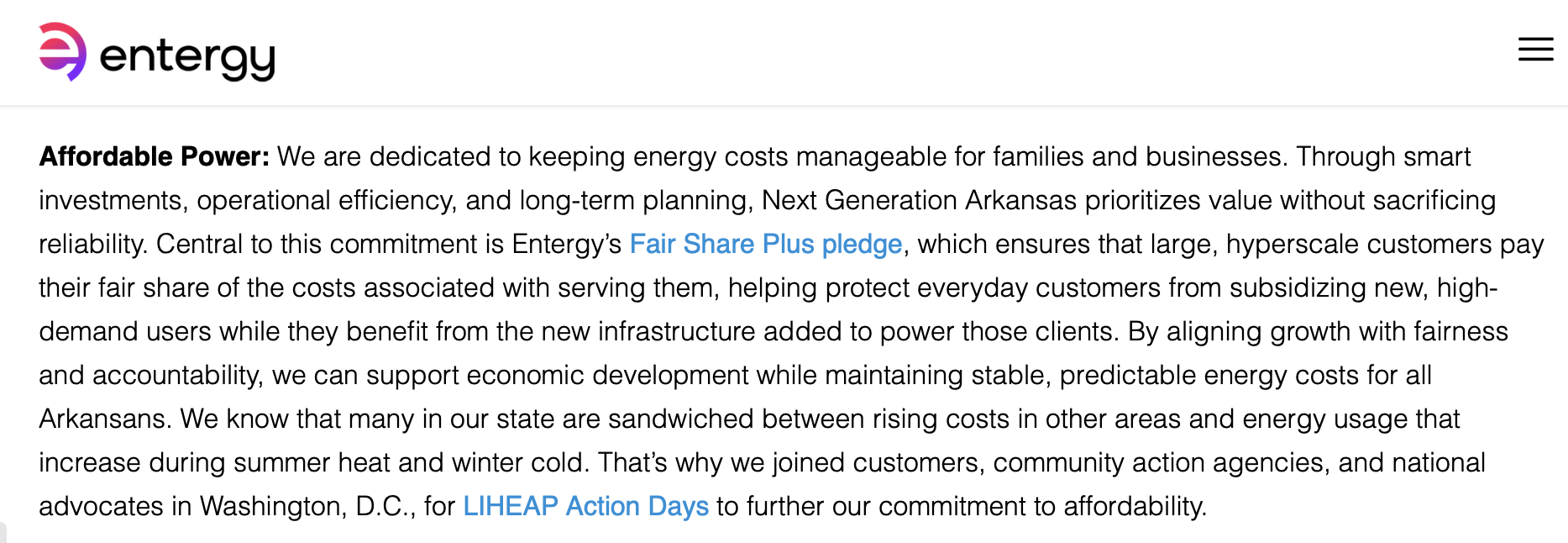

1.What Entergy Said: Existing customers would be protected from the cost of serving new data-center load.[1]
What We Know: Existing customers are already paying the full amount for the new generation. Entergy has said its agreements are structured so that existing ratepayers are not left paying for investments needed because of new large data-center loads. However, Arkansas ratepayers have already begun paying for Cypress, a $1.6 billion solar and battery project being built for new data-center demand, through the GAJA rider since June.[2]
2. What Entergy Said: Data center customer payments would support the construction of the project.[3]
What We Know: Regardless of the amount paid by the data center customer, Entergy appears to be double dipping on that amount. Whether it’s $1, $526M, or the entire $1.6B[4] Entergy will receive the same money twice: once through rates based on the full Cypress cost[5] from ratepayers, and again from the data-center customer paying toward the project.

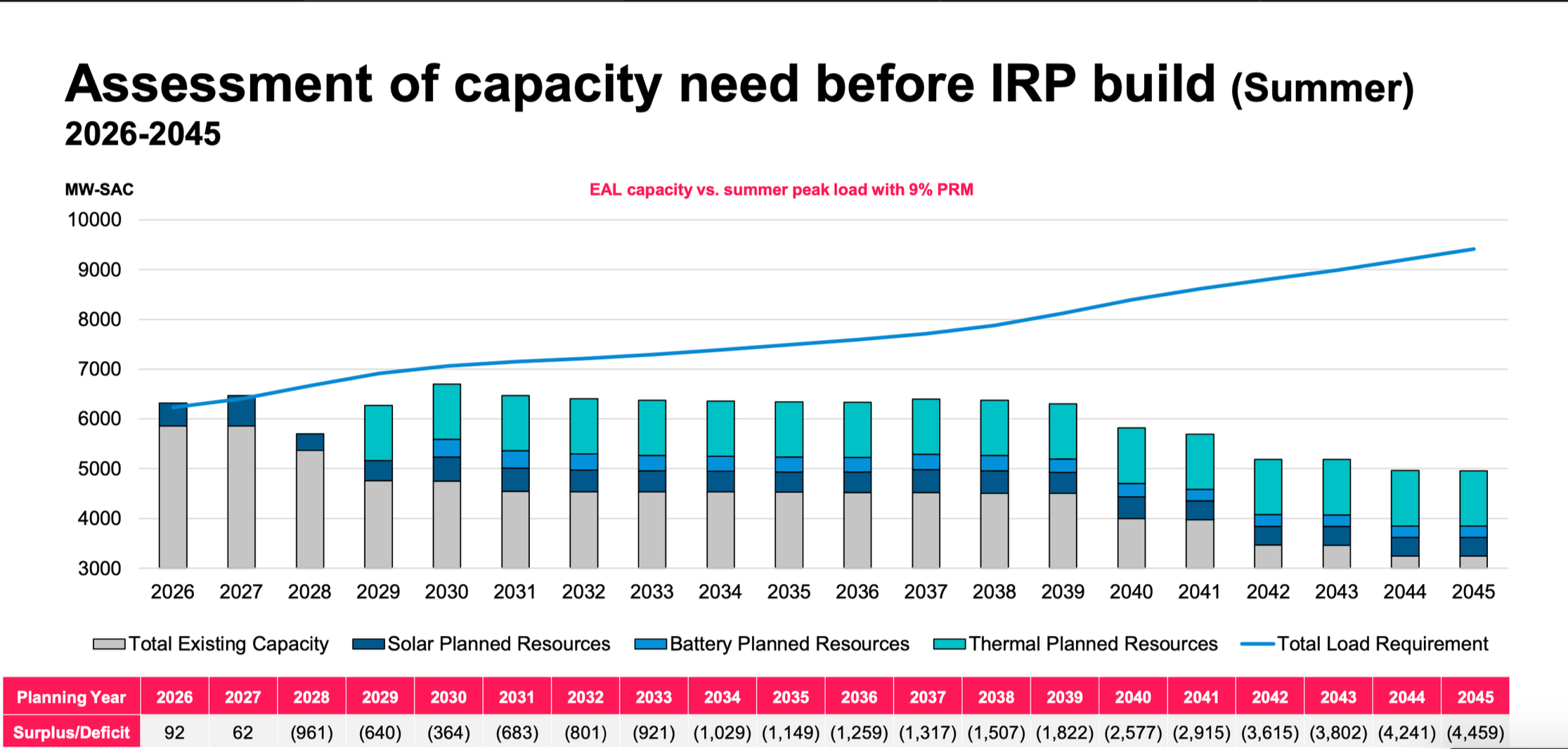

3. What Entergy Said: New generation was needed to meet Arkansas’s growing demand [6].
What We Know: After billions in new investment, we still aren't adding more power overall. Entergy is retiring approximately 2,325 MW at White Bluff[7] and Lake Catherine Unit 4[8]. Ironwood[9] and Jefferson[10] add only about 1,200–1,250 MW. Cypress[11] adds generation, but that power is earmarked for data center usage.
AAE will continue monitoring the Cypress case, future GAJA projects before the PSC, and opportunities for policy improvements during the 2027 legislative session.
